Need for IT vendor transition

IT Vendor transition is undesirable for the enterprises since vendor is selected after careful evaluation, tremendous efforts and due diligence. However, there are certain events that forces organizations to change their vendors. Reasons could be many but most prominently following factors contribute for vendor transition decisions:

  • Technology roadmap changes: Enterprises decide to shift from one technology stack to another based on product or service roadmap and business needs. Existing vendors might not have required technology expertise to deliver the desired outcome.
  • Customer need changes: Changes in the end customers’ needs drive major shift the way the business processes are implemented. Re-engineering of the business processes requires re-thinking of services or products supply by the existing vendors due to capabilities and limitations of talent and knowledge.
  • Cost impact: Vendor markets may suffer macro-economic fluctuations such as sudden spurt in the inflation in offshore countries and vendors demand price hike. It may not be possible for the organizations to meet such demands.
  • Performance issues: Degraded performance in meeting business and technology demands impact profitability and business continuity thus forcing companies to think of switching vendors.

Risks in IT vendor transition

The success of the transition depends on several parameters such as technical, financial and even soft aspects such as emotions of the people. Knowing these parameters can help you better prepare for making transition smooth process for your organization.

  • Knowledge transition: Existing vendor might not cooperate in smooth knowledge transition activities causing failed or delayed transition.
  • Person-to-Person relationship transition: Employees from the companies get accustomed and friendly with existing vendor employees and may find difficult to deal with new vendor employees.
  • Business continuity risks: Failed or delayed transition may impact business continuity. Going vendor may not want to provide ‘maintenance’ services in the event of service breakdown outside the scope of contract.
  • Budgetary risks: Poorly planned transitions may delay the implementation thus causing overshooting of budget, time and scope of transition.
  • Value alignment risk: New vendor may not get aligned to company’s value system easily. This may result in perception threats and HR issues.
  • Contractual risks: Out of scope activities can be easily ignored by the going vendor and that may cause huge damage to the company in terms of reputation, customer loyalty and money.

IT Vendor transition approaches

There can be two approaches to vendor transition, mostly governed by the urgency, budgetary constraints and overall impact of change on the business.

  • Do it once and for all: As soon as the decision of vendor transition is taken by the companies, services from the existing vendors are terminated immediately. This happens usually when the business impact of retaining the existing customer beyond few days is more adverse than terminating the services from that vendor. Example: fraud cases.
  • Phased transition approach: This is the most common approach adopted by companies to change vendors. Usually the transition is planned, friendly and carried out in a phased manner involving minimum frictions between 3 parties: vendors and company.

Risk mitigation approach

e-Zest understands the circumstances under which organizations need to transition from different vendors to us. We have evolved proven process for successful vendor transitio

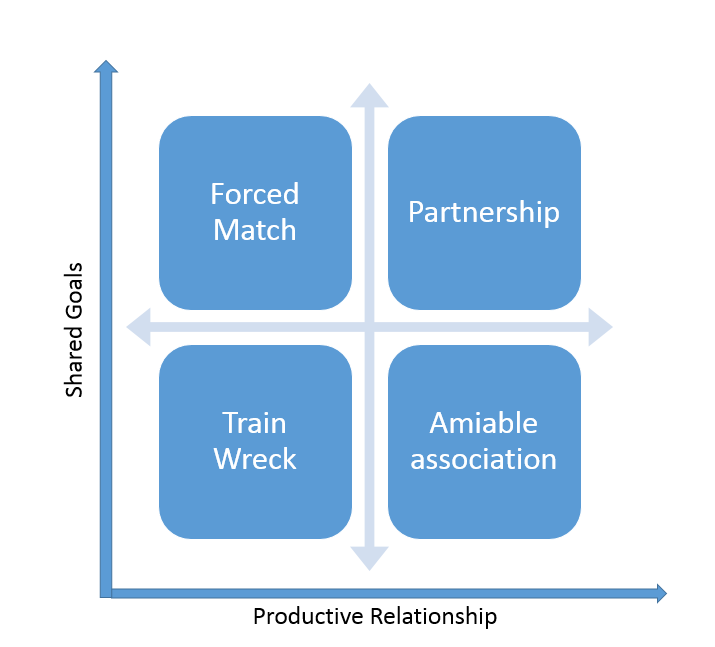

Effective person to person relationship building measures

e-Zest believes in ‘partnership’ approach wherein the emphasis is given to build highest level of productive relationship with employees of outgoing vendor and the company.


Business disruption risk

e-Zest works on business disruption minimization model to prevent and minimize the impact of business disruption, if any. e-Zest’s risk management experts evaluates the possibility of business disruption, ways to prevent discontinuity, minimize the impact in case of unavoidable circumstances and how fast it can be restored.


e-Zest approach in IT partner transition

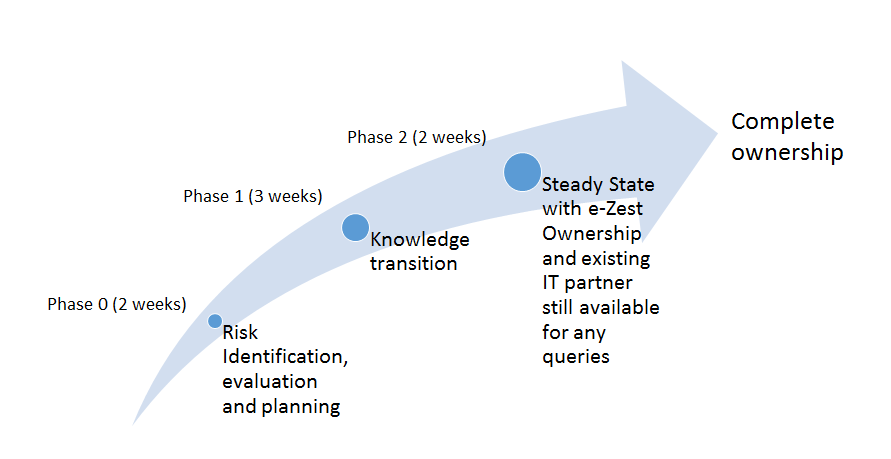

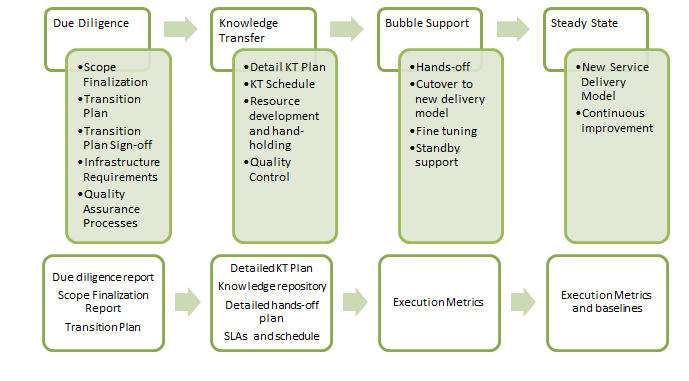

Phase 0: Risk Identification, Evaluation and Planning

  1. Daily meetings with different application owners on client side to understand the application, identify risks involved when taking ownership of application
  2. Getting  familiarized with client processes for different applications
  3. Team also reviews existing documentation and Cloud infrastructure to get understanding of the knowledge transfer that would be required from existing IT partner
  4. Identify risks and prepare a plan for mitigation
  5. Transition is prepared for an order in which knowledge transfer happens for application

Phase 1: Application deployment knowledge transition and ownership

  1.  3 – 5 applications per week are scheduled for knowledge transfer from existing IT partner for 1 week
  2.  After the knowledge transfer is done, e-Zest team starts handling day to day operations for the application
  3.  Daily 1 hour call for 1 week is scheduled with existing IT partner for any queries and clarity required

Phase 2: Steady State with e-Zest ownership

  1. Even after taking ownership of applications, limited support is available from existing IT partner for 2 weeks duration to address any clarification required
  2. Planned improvements for required architectural changes is done after doing necessary impact analysis

Value alignment

e-Zest’s OLIVZ philosophy makes sure that the client’s value system would be followed quickly and seamlessly.


Critical factors that lead to successful transition

  • Commitment from e-Zest and client top leadership
  • Onsite presence with client
  • Partnership approach
  • Well-designed transition plan
  • Speed of response
  • Selection of right resources
  • Experience team readily available to start taking ownership

Key learning

  • Timeline for knowledge transfer: Application involving higher level of judgment and local context need to have higher training and stabilization duration
  • Close interaction required for better understanding: Onsite presence helps in getting better understanding of client processes and usage
  • Technology related: Technology that has significant third party dependency need to be managed closely and tightly
  • Clear definition of scope: Rigorous approach need to be adopted to clearly define the in-scope and out of scope activities. This needs to be supported by detailed documentation
  • 100% ownership of client environment
  • 95% on time completion of knowledge transfer and training
  • Zero escalations
  • Quick transition

 Transition benefits

  • 100% ownership of client environment
  • 95% on time completion of knowledge transfer and training
  • Zero escalations
  • Quick transition

Download a Whitepaper

e-Zest is committed to protecting your data. We have designed robust controls to safeguard your data from unauthorized collection, use and disclosure.

e-Zest Solutions is digital experience engineering company with facilities in the United States (Detroit & San Jose), Germany (Hannover), United Kingdom (London UK) and India (Pune) with global clientele. Our services include custom software development, offshore software development, UX consulting, BigData, Managed cloud Services (Azure & AWS), SharePoint consulting/Migration, Enterprise Java application development, Automated software testing services.
